Metal Building Site Preparation: Everything to Do Before Your Kit Arrives

Metal Building Site Preparation: Everything to Do Before Your Kit Arrives

Metal Building Site Preparation: Everything to Do Before Your Kit Arrives

Quick Summary / Key Takeaway Box:

Delay to furnish and deliver the site to the contractor accounts for over 31% of major construction delays in the U.S., according to nationwide studies. That means nearly one-third of serious project setbacks start before a single wall goes up simply because the site wasn’t ready when it needed to be. If you’re a landowner, builder, or contractor waiting for your metal building kit to arrive, this stat should hit close to home. This highlights the critical importance of effective metal building site preparation.

You might be thinking, “I’ve already cleared the land, what else is there to do?” But the truth is, preparing your site takes a lot more than just clearing trees and leveling the ground.

Graphic showing construction delays: a red semicircle gauge labeled 100% for total construction delays and a yellow semicircle gauge labeled 31% for delays caused by site unreadiness, under the header ‘Construction Delays Due to Site Unreadiness.

From uneven grading and soft soil to poor drainage or misplaced anchor bolts, even one missed detail can stall your build, push back delivery, and add unexpected costs. That’s why we have created this step-by-step guide to metal building site preparation. Whether you’re building a workshop, garage, barn, or commercial structure, this resource will help you:

  • Avoid common (and expensive) mistakes
  • Understand each phase of the site prep process
  • Get your slab, grading, drainage, and utilities 100% ready for a smooth installation

You’ll also find a free Buildway Site Prep Checklist at the end to help you stay organized and make sure you don’t miss any important steps. Let’s walk through everything you need to do so your site is fully ready when your metal building kit arrives.

Why Is Metal Building Site Preparation So Important Before Construction Begins?

It might be tempting to jump straight into the build, especially once your kit is ordered and you’re eager to get started. But taking shortcuts during your metal building site preparation is one of the fastest ways to run into delays, added costs, and construction headaches. To ensure you start off right, make sure you know the Top 7 Biggest Metal Building Kit Buying Mistakes to Avoid. Skipping key steps or rushing through the process can lead to all kinds of issues before your building even goes up:

Graphic titled ‘Metal Building Site Preparation’ showing four panels: an unprepared building site with a barricade icon, a prevent-delays panel with a clock icon, a meet-requirements panel with a checklist and gear icon, and a prepared building site with a crane and building icon.

1. Preventing Delays and Unexpected Costs

One of the biggest reasons for construction delays isn’t the building itself, it’s an unprepared site. Without proper groundwork, even the best metal building kit can’t be installed on time. Here’s how poor site prep can lead to costly problems:

  • Delivery trucks may refuse to drop the kit if access roads are uneven or too soft.
  • Crane services get delayed when ground isn’t level or compacted enough.
  • Concrete rework may be required if your pad isn’t poured to spec.
  • Additional grading or drainage corrections can cost thousands after the fact.

2. Meeting Manufacturer and Local Building Requirements

Every metal building kit comes with detailed specs from the manufacturer, and local codes often add even more layers of compliance. If your site doesn’t meet these standards, you could face major delays before construction even starts. Here’s what’s typically required:

  • Manufacturers often provide exact specs for anchor bolt placement, pad thickness, and slab size.
  • Local inspectors may check for soil compaction, setbacks, and utility readiness before approving your build.
  • Without proper prep, you risk permit delays, failed inspections, or structural complications later.

In short, good site prep is essential. Whether you’re building a small garage or a large commercial structure, laying the right groundwork saves you time, money, and stress.

So, What Does Proper Metal Building Site Preparation Actually Involve? Let’s break it down step by step, starting with evaluating and clearing your building site.

Step 1: Evaluate and Clear the Building Site

Before you can grade, pour concrete, or begin construction, you need to properly evaluate and clear the site. This step lays the foundation for everything that follows and getting it right can save you from costly rework later.

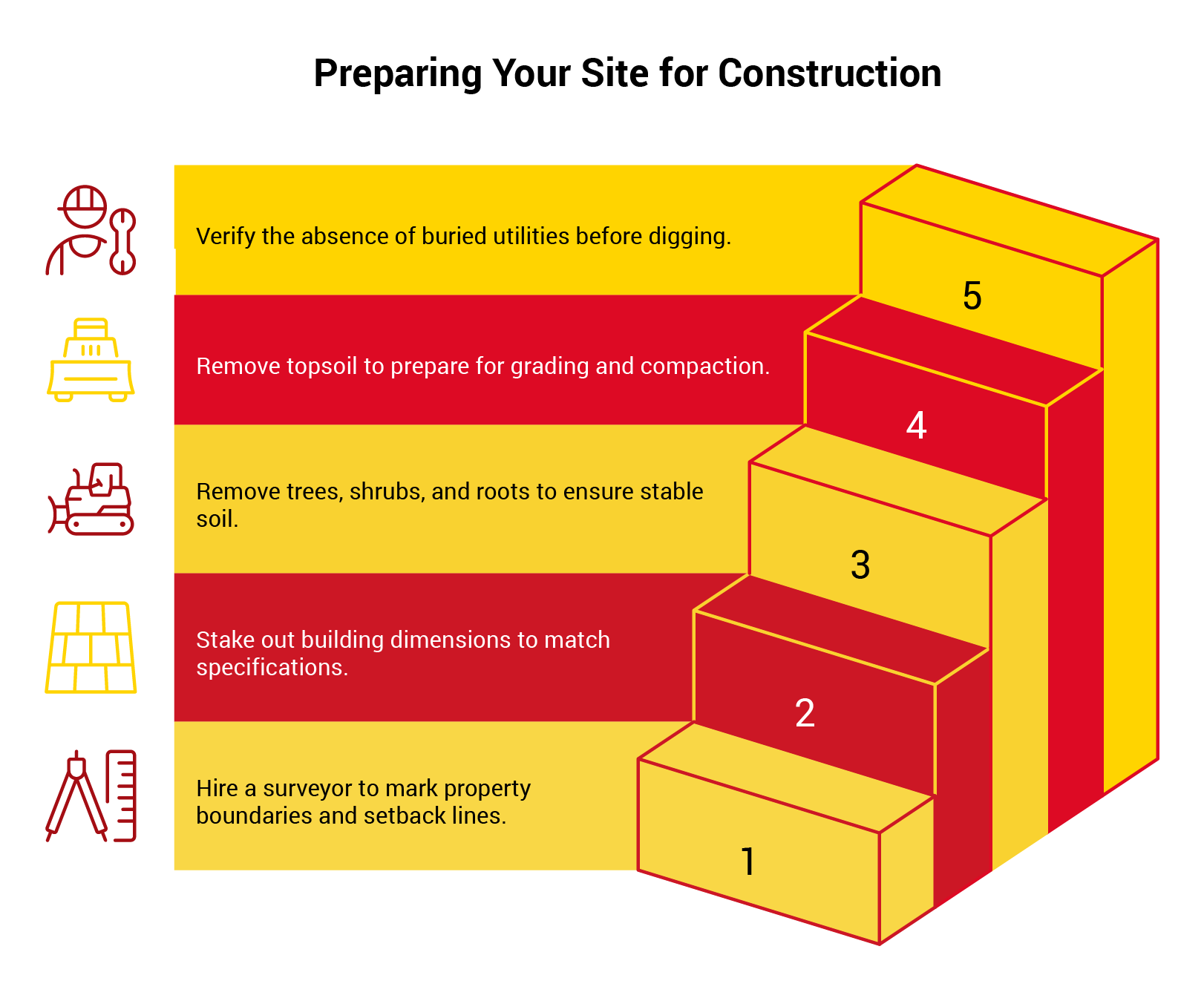

Illustration titled ‘Preparing Your Site for Construction,’ showing a five-step process displayed as ascending blocks: 1) hire a surveyor to mark property boundaries, 2) stake out building dimensions, 3) remove trees and roots for stable soil, 4) remove topsoil for grading and compaction, and 5) verify no buried utilities before digging. Icons representing each task appear on the left.

Surveying, Marking, and Staking the Build Area

Start by identifying exactly where your building will sit on the property. This ensures you’re building within legal boundaries and in the right location for utility access and drainage flow.

Here’s what this part of the process typically involves:

  • Hire a licensed surveyor to verify property boundaries and mark setback lines.
  • Stake out exact building dimensions to match your slab and kit specs.
  • Include space for crane paths, delivery trucks, and staging areas during construction.

Pro Tip: Don’t forget to account for room around the pad for gutters, future expansion, or maintenance access.

Removing Trees, Debris, and Topsoil

Once your layout is marked, it’s time to clear the site and prepare the ground. This step ensures your foundation rests on solid, stable soil.

Here’s what needs to be done during the clearing phase:

  • Remove all vegetation, including tree roots and large shrubs that could cause slab shifting.
  • Strip away topsoil, which is too loose and rich in organic matter to support a building pad.
  • Aim for a clean, level subgrade to prepare for grading and compaction.

Pro Tip: Always check for buried utilities before digging. Use 811 or your local utility marking service.

A huge number of these problems can be avoided entirely with proper site readiness. If you don’t have a clear plan for grading, drainage, slab prep, and access, you’re setting yourself up for delays before your kit even arrives. That’s why we built a full metal building site preparation guide that walks you through every step.

Step 2: Grading for a Steel Building

Once your site is cleared and marked, the next crucial phase is grading. This step is about creating a stable, well-drained foundation that supports your concrete pad and prevents long-term issues. Proper grading ensures your building won’t suffer from standing water, erosion, or shifting soil, and it helps you pass key inspections required before construction can begin. Here’s what to focus on:

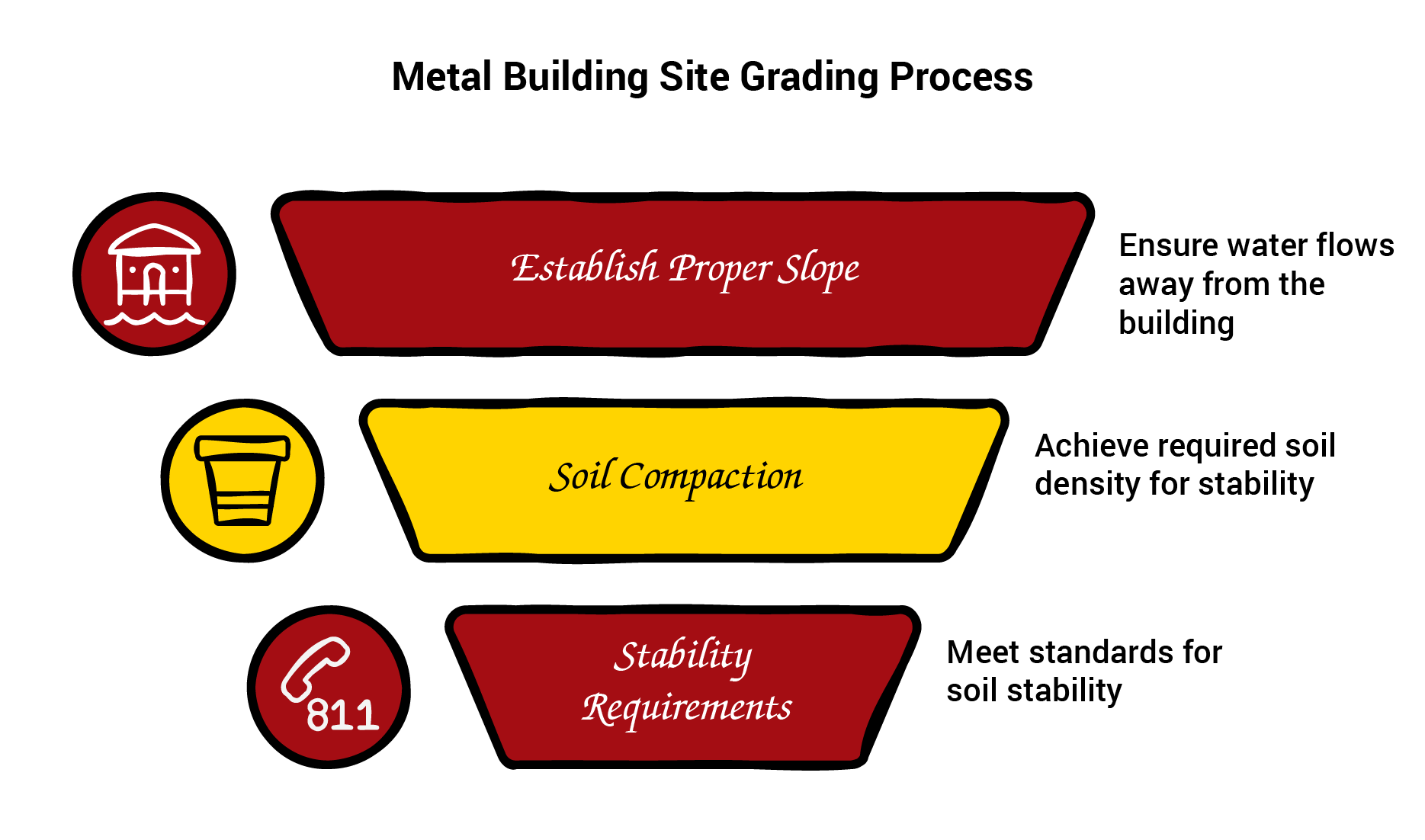

Diagram titled ‘Metal Building Site Grading Process’ showing three grading steps: establishing proper slope to direct water away from the building, soil compaction to reach required density, and meeting soil stability requirements. Each step appears in a red or yellow trapezoid with matching icons on the left.

Establishing Proper Slope

One of the most important grading goals is to manage water flow. A well-graded site should direct rainwater away from the building, not toward it. Here’s how to ensure your site has the right slope:

  • Grade the site to ensure a minimum slope of 5% (6 inches per 10 feet) away from the building on all sides.
  • This slope prevents water from pooling near your foundation, which can lead to erosion or structural damage.
  • Use a laser transit or hire a grading contractor for precision.

Tip: Poor drainage is one of the most common causes of foundation issues. Don’t skip this step!

Soil Compaction and Stability Requirements

Once you’ve established your grade, it’s time to compact the soil. This is what gives your slab a firm base and ensures it won’t settle unevenly over time. Here’s what’s typically involved in compaction:

  • Achieve 90–95% Standard Proctor Density for reliable support.
  • Use a vibratory roller or plate compactor to compress layers of fill and base material.
  • If soil is soft, sandy, or clay-heavy, consider importing engineered fill like crushed stone or select fill.

Inspection Tip: Many counties require a compaction test before pouring concrete. Ask your local building department.

Step 3: Concrete Pad Preparation

Your concrete pad is the foundation that supports your entire metal building. If it’s not done right, even a perfectly designed steel structure won’t install correctly or hold up over time. This step requires attention to detail, precision, and the right materials. From the gravel base to bolt placement, every part of the pad must be planned and executed carefully. Here’s what you need to get right:

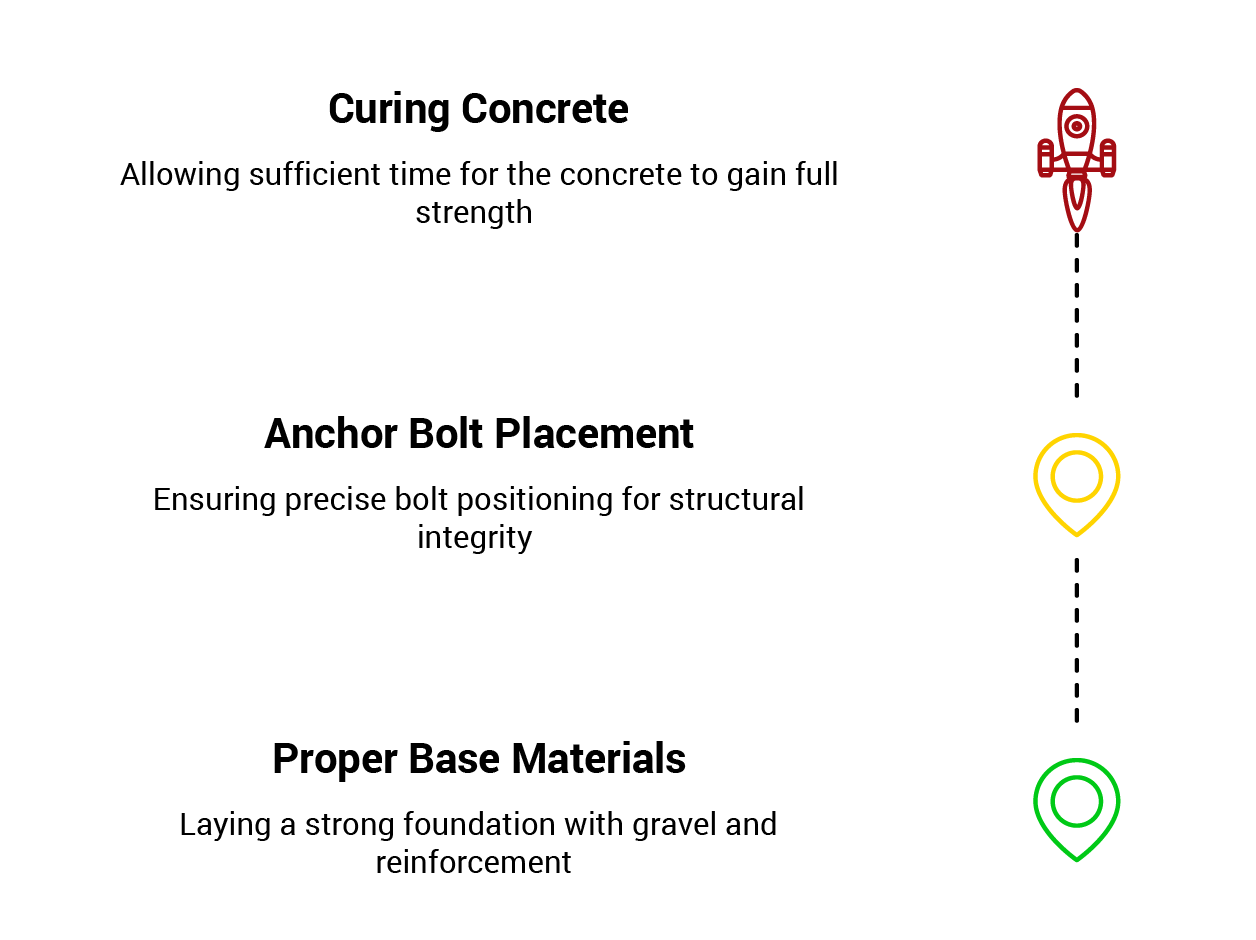

Graphic titled ‘Preparing a Concrete Pad for Metal Building,’ outlining three steps: curing concrete to reach full strength, accurate anchor bolt placement for structural integrity, and using proper base materials such as gravel and reinforcement. Each step is paired with a red, yellow, or green icon along a vertical dashed path.

Proper Base Materials

A strong slab starts from the ground up, literally. Using the right base material and reinforcement ensures your pad won’t crack, shift, or fail under load. Before pouring your slab, make sure to:

  • Use 4–6 inches of compacted gravel or crushed stone as a base beneath the slab.
  • Install rebar or wire mesh for reinforcement, based on load requirements (e.g., vehicles, machinery).

Standard slab thickness is:

  • 4 inches for basic garages or storage buildings
  • 6+ inches for shops, warehouses, or heavy equipment

Tip: Always check local code requirements or ask your contractor to confirm thickness and reinforcement specs.

Anchor Bolt Placement for Metal Building Kits

Anchor bolts connect your steel building to the concrete and their placement must be exact. Even a small misalignment can throw off your entire build. To make sure your anchor bolts are installed correctly:

  • Anchor bolts are not optional. They secure the steel frame to the concrete.
  • Follow the exact template and spacing provided by your metal building manufacturer.
  • Use wooden or steel templates to hold bolts in position while the concrete is poured and sets.

Common Mistake: Incorrect bolt placement = installation delay + expensive fix. Triple-check with your supplier’s layout.

Typical Timelines for Curing Concrete

Once poured, your slab needs time to cure properly before any construction begins. Rushing this stage can lead to surface cracks or reduced strength. Here’s what to expect with curing:

  • Wait a minimum of 7 days before any structure assembly.
  • Allow 28 days for full strength.
  • Cold, wet, or humid conditions slow curing. Use curing blankets or additives if needed.

Weather Warning: Cold temperatures can significantly slow curing. Always plan your pour around seasonal conditions if possible.

Get a quick review from a Buildway Site Prep Specialist before you pour a dollar into concrete. Contact us Today.

Step 4: Drainage Requirements You Can’t Skip

Water might not seem like a big issue during the early stages of construction but improper drainage is one of the most common causes of foundation problems in metal buildings. From slab cracks to erosion and even interior flooding, moisture-related damage can cost thousands in repairs. That’s why planning for drainage is just as important as pouring a solid slab. Here’s what to focus on to protect your building for the long term:

Graphic titled ‘Prevent Foundation Problems with Proper Drainage,’ showing four steps: perimeter grading to slope ground away from the slab, gutter installation to collect rainwater, downspout extension to direct water away from the slab, and stormwater planning to safely route runoff. Foundation problems and protected building outcomes are shown at the bottom.

Perimeter Grading for Water Flow

Your first line of defense against water damage is the ground around your foundation. If it slopes toward the building, you’re asking for trouble. Here’s how to manage perimeter grading properly:

  • Ensure the finished grade slopes away from all sides of the concrete slab. Ideally at least 5% (6 inches over 10 feet).
  • Create shallow swales or berms to guide water away from the building and toward proper drainage areas like ditches or retention basins.
  • Double-check that there are no low spots or pooling areas near the foundation edges.

Why it matters: Standing water next to the slab weakens soil, invites erosion, and may seep into the interior of your building over time.

Gutter, Downspout, and Runoff Planning

Once your building is up, the roof will shed a lot of water and you need a plan for where that water will go. To manage roof runoff effectively:

  • Install gutters and downspouts as part of your final building assembly. These help collect and control rainwater from the roof.
  • Extend downspouts using splash blocks, flexible drain pipes, or French drains to keep water away from the slab.
  • If your property is in a flood-prone area, consider raising the slab slightly above grade and designing a stormwater plan that routes water safely away.

Extra Tip: FEMA and many local jurisdictions require specific drainage plans in flood zones. Check your zoning map or consult your local building department to make sure you’re in compliance.

Step 5: Utility and Access Prep Before Delivery

It’s easy to get caught up in grading and concrete work but don’t overlook utilities and site access before your metal building kit arrives. These two areas are often afterthoughts, but failing to prepare them in advance can lead to delays, added costs, and avoidable construction headaches. Here’s what to plan for before delivery day:

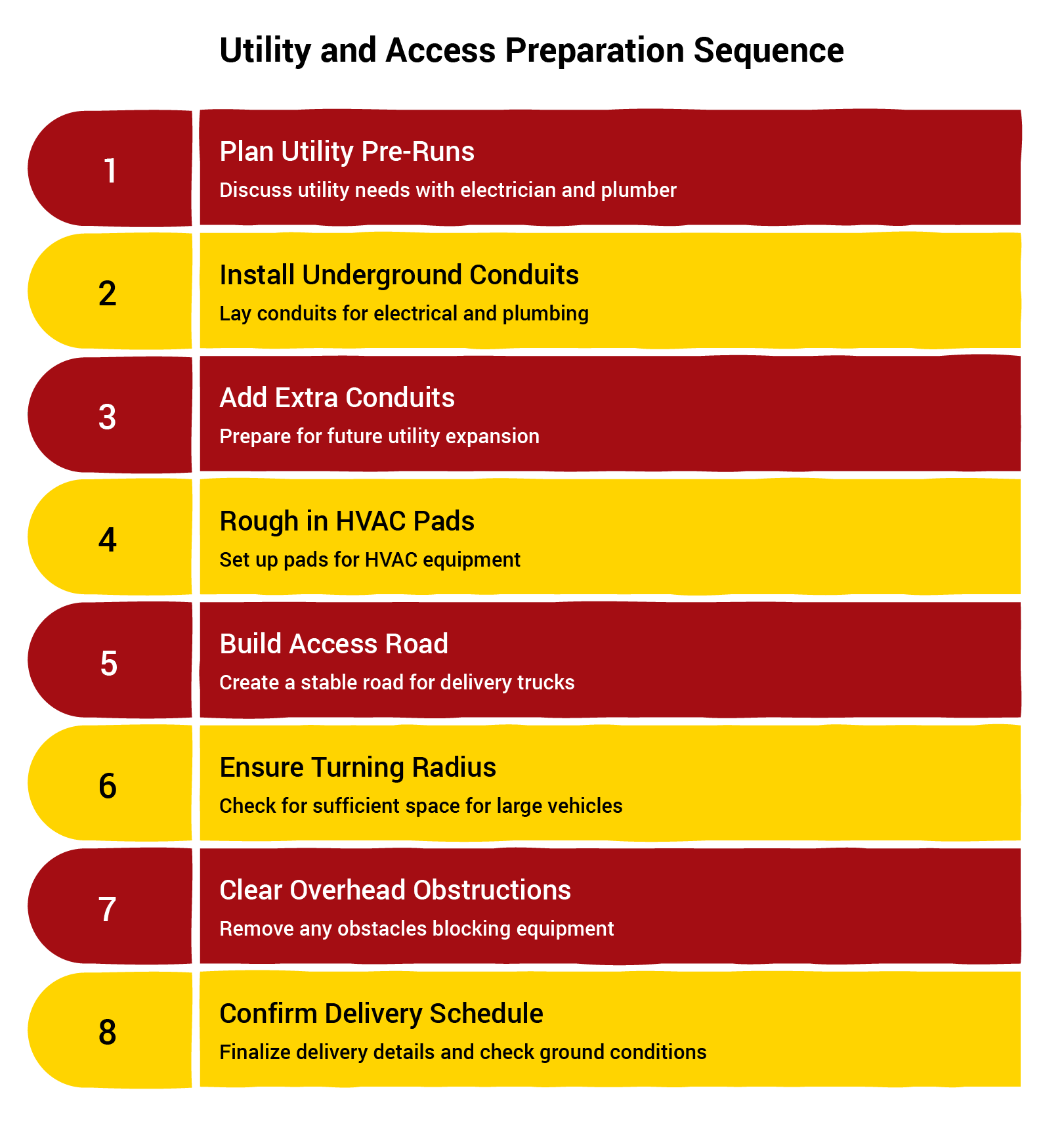

Graphic titled ‘Utility and Access Preparation Sequence,’ listing eight steps: plan utility pre-runs, install underground conduits, add extra conduits, rough in HVAC pads, build access road, ensure turning radius, clear overhead obstructions, and confirm delivery schedule. Each step is displayed in alternating red and yellow panels with numbered circles.

Electrical, Plumbing, and HVAC Pre-Runs

If your building will have power, water, or climate control, you’ll want to rough in these utilities before you pour the slab. Doing it after the fact usually means cutting into freshly poured concrete, not ideal. Here’s what you should take care of ahead of time:

  • Install underground conduits, water lines, and drain pipes before the slab is poured.
  • Add extra conduits or stub-outs if you’re planning future expansion, it’s much easier to do now than later.
  • Proper metal building site preparation includes roughing in HVAC pads, floor drains, or anchor points for equipment, car lifts, or any other permanent features.

If you are planning a garage, knowing What’s the Best Way to Design a Metal Garage Kit for Your Property Layout will significantly help with your utility planning.

Planning Tip: Walk through your floor plan with your electrician and plumber beforehand to avoid last-minute changes.

Ensuring Delivery Trucks and Cranes Have Access

No matter how prepared your site is, if the kit can’t be delivered or equipment can’t get in, your build is on hold. Make sure the path to your site is solid, wide, and clear. Here’s how to prep for a smooth delivery:

  • Build a stable access road, a packed gravel drive works well for most rural or undeveloped properties.
  • Make sure there’s enough turning radius for flatbed trucks, semi-trailers, and cranes if they’re required for installation.
  • Clear any overhead obstructions, including low-hanging tree branches, utility lines, or other hazards that could block equipment.

Access Tip: Confirm your delivery schedule and make sure the ground won’t be muddy or too soft, especially during rainy seasons. A stuck truck can delay your project and cost extra.

Step 6: Final Inspection Checklist

Before your metal building kit arrives and installation begins, it’s essential to do one last walk-through of your site. This final inspection ensures everything is in place, meets code, and aligns with your building manufacturer’s specs. Skipping this step or assuming everything is ready, can lead to failed inspections, construction delays, or costly rework. Use this final checklist to make sure your site is truly ready for delivery.

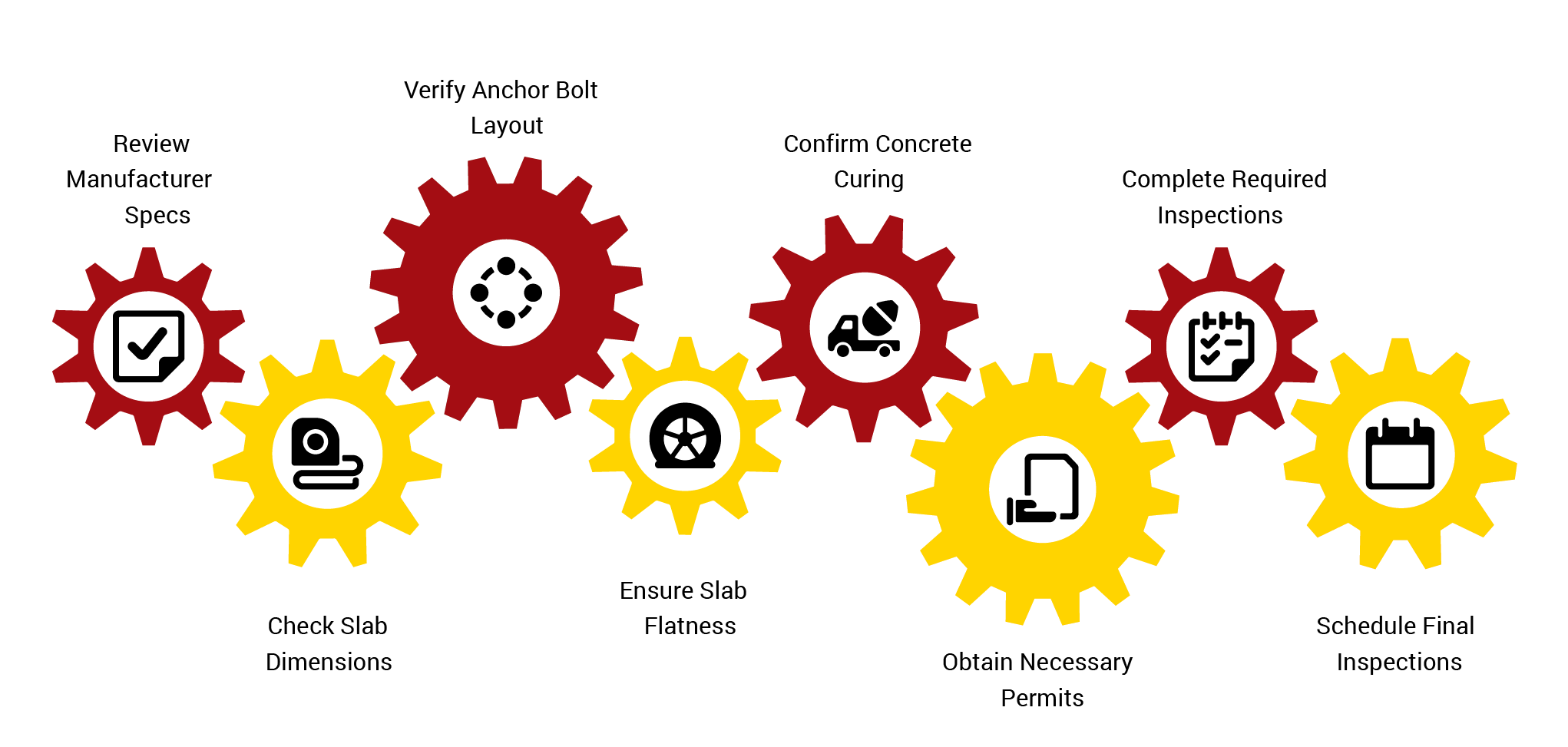

Graphic titled ‘Final Inspection Checklist for Metal Building Kit Installation,’ showing a series of red and yellow gear icons, each representing a task: review manufacturer specs, check slab dimensions, verify anchor bolt layout, ensure slab flatness, confirm concrete curing, obtain necessary permits, complete required inspections, and schedule final inspections.

Manufacturer-Required Checks

Each building kit comes with specific structural and foundation requirements. Before your building arrives, double-check that your site meets the manufacturer’s specs exactly. Here’s what to confirm:

  • Slab dimensions match the building plans provided by the kit manufacturer
  • Anchor bolt layout and placement are accurate and match the template
  • Slab is flat and level within 1/8″ to 1/4″ tolerance over 10 feet
  • Concrete has cured for the required amount of time (typically a minimum of 7 days)

Reminder: Refer back to your bolt plan or template from the supplier before making any final calls.

Local Code Requirements

In addition to manufacturer checks, you also need to ensure your site complies with local building regulations. Most jurisdictions require certain inspections before, during, or immediately after site prep.

Make sure you’ve:

  • Obtained and posted all necessary permits for foundation, grading, and utilities
  • Completed any required inspections, such as soil compaction, setback verification, or slab prep
  • Scheduled final pre-construction inspections with your local building department, if required

Helpful Tip: Keep a folder (digital or printed) with your permits, approved plans, inspection records, and contractor contact info. It’ll save time during reviews. Once all items on this checklist are confirmed, your site is officially ready for delivery and installation.

If you want a build that starts on time and installs without drama, let the pros handle the groundwork. Schedule a Buildway Site Prep Consultation. Call us now.

Conclusion

If you want your project to start on time and avoid the costly setbacks that derail so many builds, you can’t afford to treat metal building site preparation as an afterthought. The ground you build on dictates everything that comes next: your schedule, your budget, and the long-term durability of your structure.

By following each step in this blog and taking metal building site preparation seriously from day one, you’ll set yourself up for a faster installation, fewer surprises, and a building that performs exactly the way it should. Download the free Buildway Site Prep Checklist and make sure your site is truly ready before your kit arrives.

FAQs: Metal Building Site Preparation

1. Do I need a permit before starting metal building site preparation?

Yes, in most areas, you will need permits before beginning site prep activities such as grading, excavation, or pouring concrete. Always check with your local building department to verify requirements, as regulations vary by location. Starting without permits may result in fines or project delays.

2. How do I check for underground utilities before digging?

Call 811 or your local utility locating service before any excavation work begins. This free service will mark the location of underground utilities like gas, water, and power lines. It’s legally required in many areas and ensures your project starts safely and without unexpected interruptions.

3. Can I install plumbing or electrical after the slab is poured?

Technically yes, but it’s much more expensive and time-consuming. If you plan to run plumbing, electrical, or HVAC through the slab, it’s best to rough in all utility lines before pouring concrete. This prevents the need to cut into the slab later, which can compromise its integrity.

4. How can I tell if my building site is level enough?

To ensure your concrete pad meets manufacturer standards, use a laser level or hire a licensed surveyor to check the elevation. Most metal building kits require the slab to be level within 1/8″ to 1/4″ over a 10-foot span. Even small uneven areas can cause alignment issues during installation.

5. What should I do if my soil isn’t stable enough for a foundation?

If the soil is too soft, loose, or expansive, you’ll need to consult a soil engineer or experienced grading contractor. Solutions may include:

  • Replacing native soil with compacted, engineered fill
  • Using geogrid or soil stabilization fabric
  • Implementing moisture control or drainage improvements

Proper soil preparation is essential to prevent slab settling or structural issues over time.
